Tuesday, April 30, 2013

CORPORATE OFFICE ON SCHEDULE

Mother nature can't seem to make up her mind as the clouds broke up this past weekend to give us a glimpse of the sunshine but now it's back to the cloud filled sky and rain. The good news is that it hasn't slowed progress on the construction of the corporate office. As we near the completion date (toward the end of June), coordination will be essential. You'll see in the photos below, we are getting to the final aspects of construction; flooring is gettting installed, walls are being painted, and they're even scrubbing floors in the kitchen.

Take a look..........

As always, I'll start the tour at the front entrance. Some of the exterior appeal of the building is starting to take shape. At ground level you'll notice the concrete forms which will eventually be planter boxes. The temporary plastic and 2x4 framing is being dismantled as the glass is installed.

This is another planter box located just outside the main entrance. Just a brain storm here but maybe we could use it as a barbeque pit for the grand opening.

Inside the front entrance the stairs and railing have been installed. The bridge to the silo is serving a practical purpose for the time being - storage.

Here's another look at the steps to the second level. The railing is made up of steel and strands of cable.

Look at this picture long enough and you may experience vertigo. Did the scissor lift tip over? The wood you're seeing on the ceiling isn't actually wood. It's some kind of a metal material. I couldn't tell exactly what it was from 20 plus feet away.

Laminated support beams for the bridge from here to there. This will span over one of the water retention areas connecting walkways.

I told you they're scrubbing floors. This is the commerical kitchen that will be used to cater events in the conference area.

Here is the wing formerly known as The Ag Tech Center. The new and improved name is The IQ Hub named as such because it's guaranteed to increase your IQ by educating you about the past, present, and future of agriculture.

This is the ADA compliant restroom in the ADA compliant overnight room. Of the five overnight rooms in the building, one is required to have ADA accessibility.

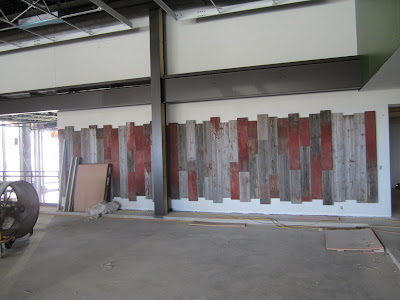

This is a conversation piece. It's one of the many parts of the building where the architect used recycled materials to tie the agricultural theme into the modern technological capabilities of the building. It could also be used as a back stop for an indoor shooting range. Multi-tasking is always good.
They call this siding style a rain screen. I would love to tell you why but I'm not sure. When it's installed this will give the building an old barn look from the west elevation.

The windows in the upper office area have been installed. Whoever gets to sit on the other side of this glass will get a nice view of the sunset over the horizon (if they work long enough).

One of the upper level corner private offices. This is the office to strive for. When you make it here, you know you made it big.

If you look through the framing and glass and past the dirt pile you can see the excavating equipment on the corner of M-21 and Dewitt Rd. They are attempting to finish up the water and sewer, which has been a grueling process through the winter months. Fortunately, the lines and structures along M-21 are nearly complete and they can start on the site utilities.


Tuesday, April 9, 2013

THE LATEST IN LIQUID CONSTRUCTION

I'll start by apologizing for the month long lapse since my last post. I know avid viewers and readers have been checking the blog site by the hour looking for the lastest news at the sites. A lot has happened over the last month - mostly at the new Stockton site. At this point in the project, the building is complete, the fluid handling components are installed, the concrete work is complete, and the final grade work will be finalized by the end of this week. Final inspections will be called in starting next week and then we'll need to start planning for phase II.

STOCKTON


The finished product with the new ADA parking spots. I'll refer to this side as the front of the building even though it's 90 degrees to the road.

 The entry side of the building. Load Bays 1 & 2.


As you can see the entry side of the building faces the rail. We have room on the currrent rail to hold 8 cars. The length of the site gives us the ability to double the length of the current rail by adding to the head.


North side or back of the building. Overhead doors are partially installed in this photo. The exhaust fan is fully installed on the roof (see the mushroom in the distance).


Ron, Randy, Tony, and I made a couple week long trips to install tanks and plumbing components. In this photo Ron is working on the micro loading station which includes a scale and weigh pot.


Randy's working on the installatioin of the steel rings that wrap around the base of the tanks. This is a new application for us. It was required because of the CA seismic loads.


As you can see, I love having my picture taken. However, I had to include this to prove to my wife that I am actually working during my travels.


Truck load out office pre-paint. Once again the NCRS fabrication shop did a beautiful job on the steel structure and stairway.


This is the 250 gallon weigh pot provided by one of our new vendors, Kahler Equipment. It will be used to mix micros and inject them in line during the loading process.


Front view of the Kahler weigh pot system. The rack will hold 4 totes on top and 4 underneath. The hoses in the photo each have a valve that will be fastened to each tote.


 Utility room for electrical panels, compressors, and communication components.


View of load bays from atop the utility room.



Rail load out office and rail pump. This pump will be used for unloading rail cars.


Say Cheese!! Here is Steve from Kahler Automation going over the load out system with Marcello. To bring everyone up to speed, Marcello is the newest AgroLiquid employee at the site in Stockton, CA. They are standing inside the elevated truck load out office.

WILLIAMS
Construction in Williams will be picking back up next week. We've been sitting idle through the winter as you'll see from the limited amount of photos.

The completed 60x100 truck load out building - signs and everything.


 Rail load out office pre-paint.


OK. So this doesnt' have much to do with a project. But it assisted with getting me to a project. Nick and I took the Merididan to Williams for a day trip and what a way to travel. You can't get much more efficient than a Williams trip in 2 hours while working on the lap top and keeping a close eye on the Krispie Kremes in the seat in front of you. Maybe next time Nick will take the back seat and let me fly.


And back home we go. Taking off from Iowa Falls Airport.
